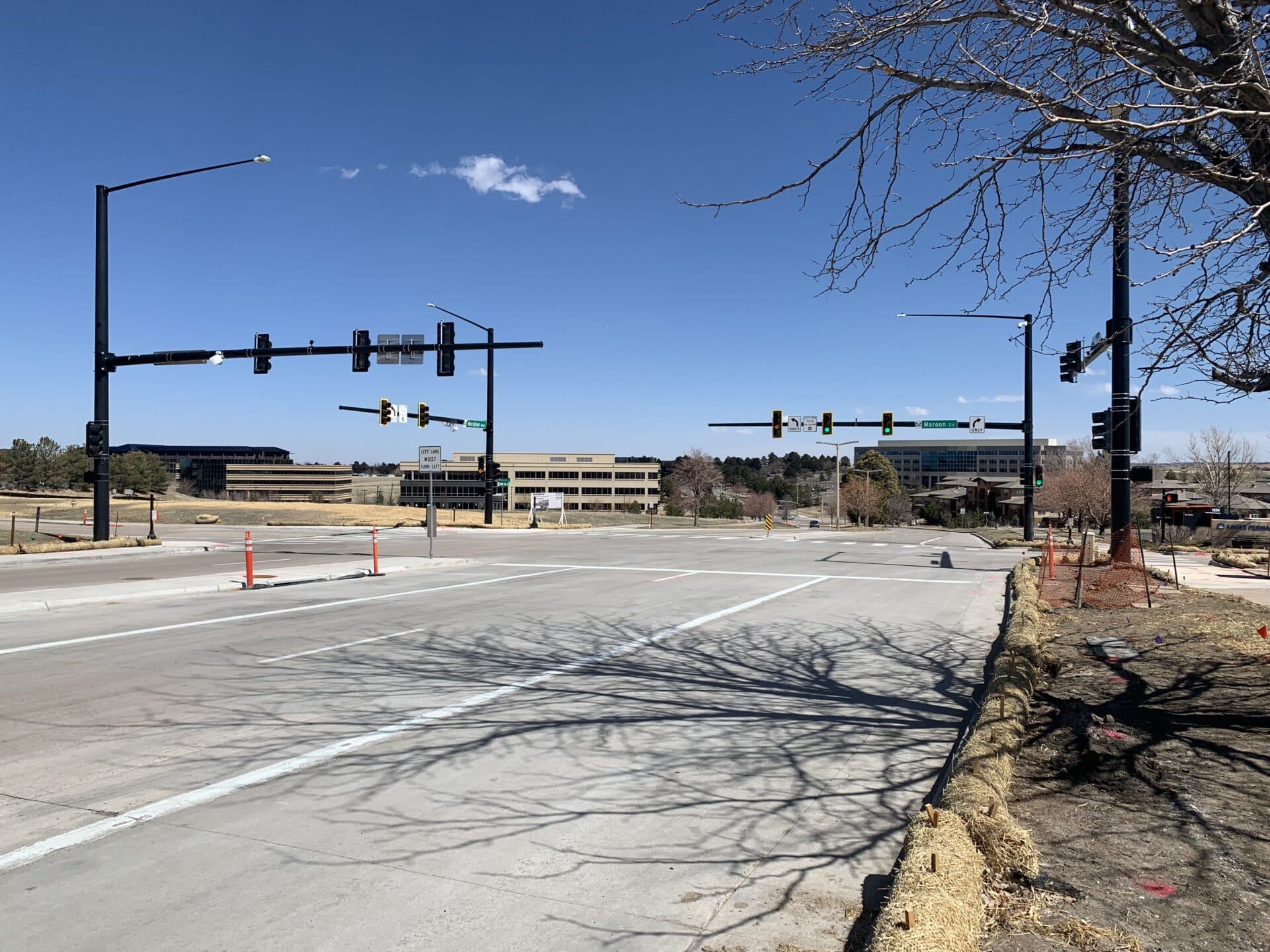

Traffic Control for Phase 2 of the project is still in place and a temporary span wire signal is operational to direct traffic during construction.
October 19 – November 2:
- Major construction activities over the next two weeks consist of concrete paving including sidewalk, median cover, curb, and gutter, storm sewer inlet construction, and traffic signal construction.
- Traffic control is anticipated to be changed to Phase 3 in late October. Current traffic control measures will be in place for drivers and pedestrians to follow. See detour map
- Construction will take place Monday through Friday from 7 a.m. to 7 p.m. with some work on the weekends.
The project is anticipated to be completed by December 8, 2022.
